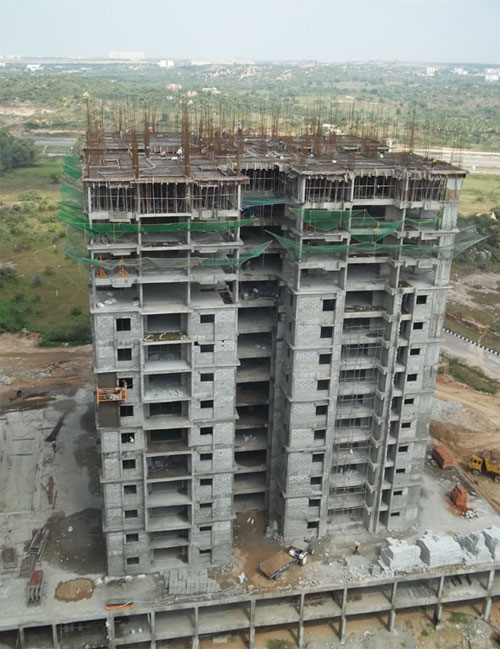

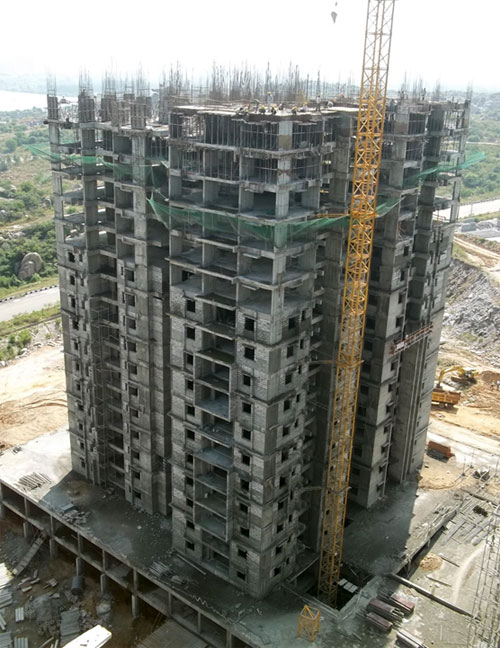

BLOCK-B: 18th FLOOR SLAB CONCRETING COMPLETED ON 20th Oct 2012
BLOCK-C : 17th FLOOR SLAB CONCRETING COMPLETED ON 30th Oct 2012
BLOCK-A: 15th FLOOR SLAB CONCRETING COMPLETED ON 26th Oct 2012
BLOCK-D: 12th FLOOR SLAB CONCRETING COMPLETED ON 17th Oct 2012

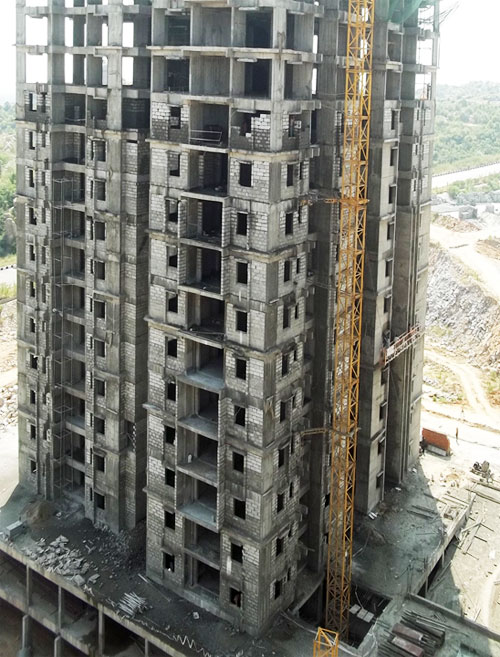

BLOCK-B: BLOCK WORK COMPLETED UP TO 15TH FLOOR AND WORK IN PROGRESS AT 16TH FLOOR, EXTERNAL PLASTER WORK IN PROGRESS
BLOCK-C: BLOCK WORK COMPLETED UP TO 12TH FLOOR AND WORK IN PROGRESS AT 13TH FLOOR, EXTERNAL PLASTER WORK IN PROGRESS
BLOCK-A: BLOCK WORK COMPLETED UPTO 9TH FLOOR AND WORK IN PROGRESS AT 10TH FLOOR , EXTERNAL PLASTER WORK IN PROGRESS
BLOCK-D: BLOCK WORK COMPLETED UPTO 8TH FLOOR AND IN PROGRES AT 9TH FLOOR.
SWIMMING POOL AREA: SUMP RAFT & WALL CONCRETING IN PROGRESS
CLUB HOUSE AREA: FOOTING & COLUMN CONCRETING IN PROGRESS

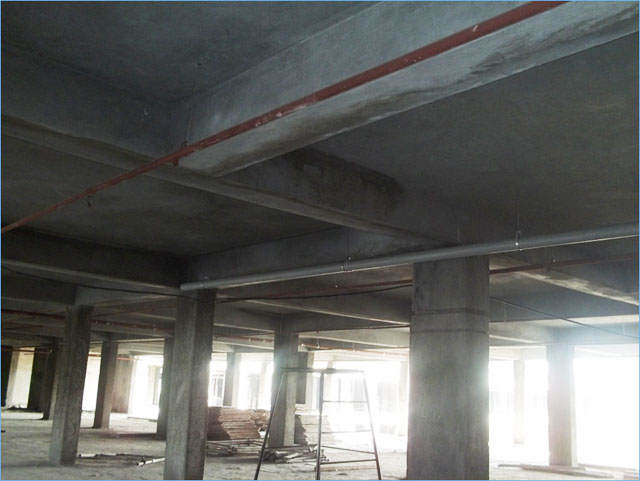

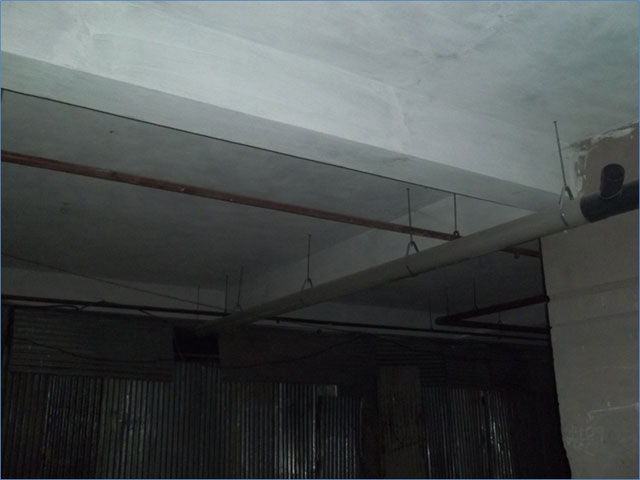

MEP (SERVICES) WORKS IN PROGRESS AT CELLAR AREA OF ALL THE FOUR BLOCKS
